50 Howick Road Offices

TIMELINE

01

03 November 2023Site Establishment

We began by clearing and preparing the site, setting up essential services and creating a safe, organized base for our own office build.

Graphic
02

15 November 2023Earthworks

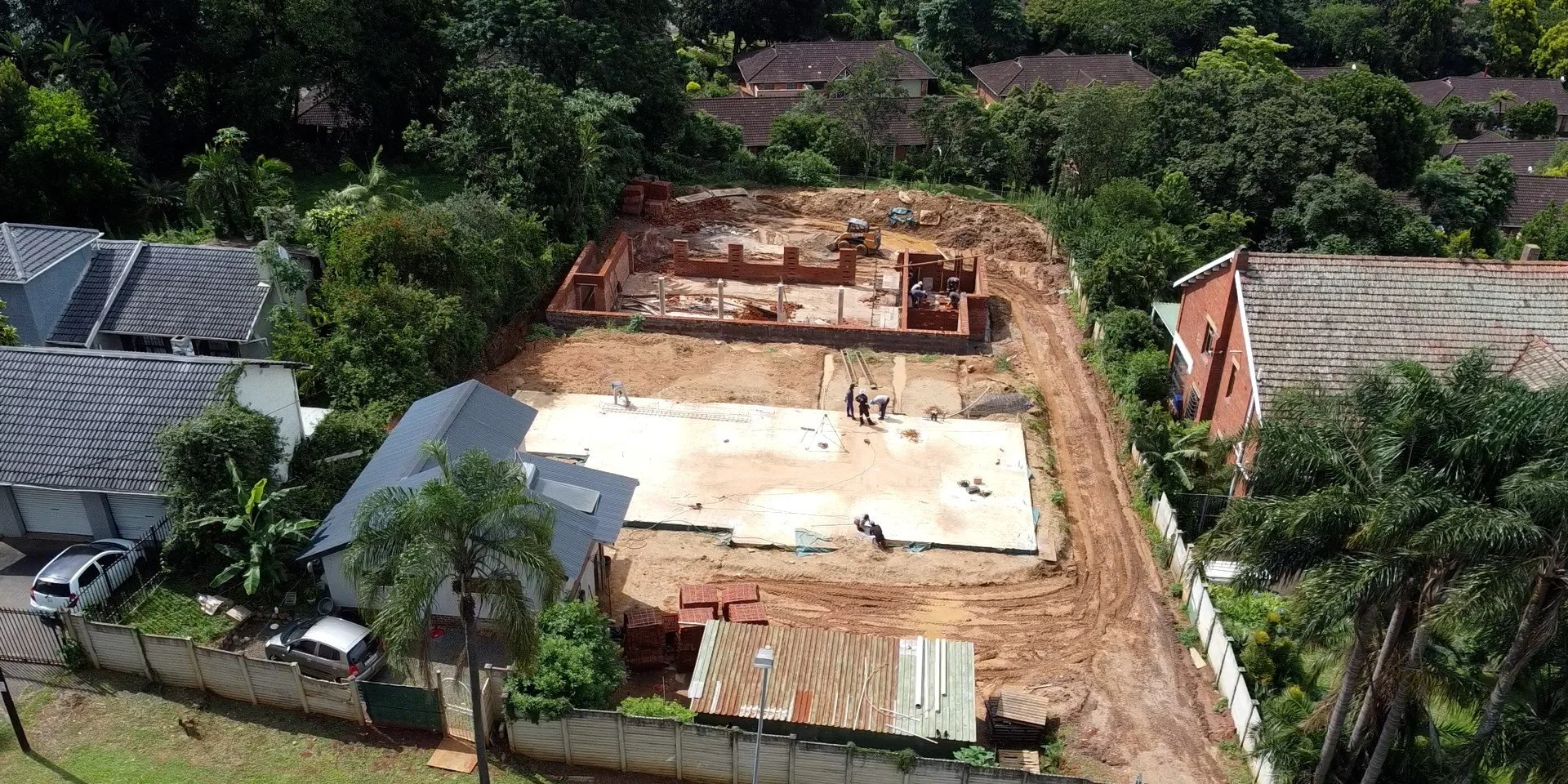

Bulk earthworks and new retaining walls were completed to stabilize the ground and prepare the platform for construction.

Graphic
03

23 November 2023Concrete Foundations

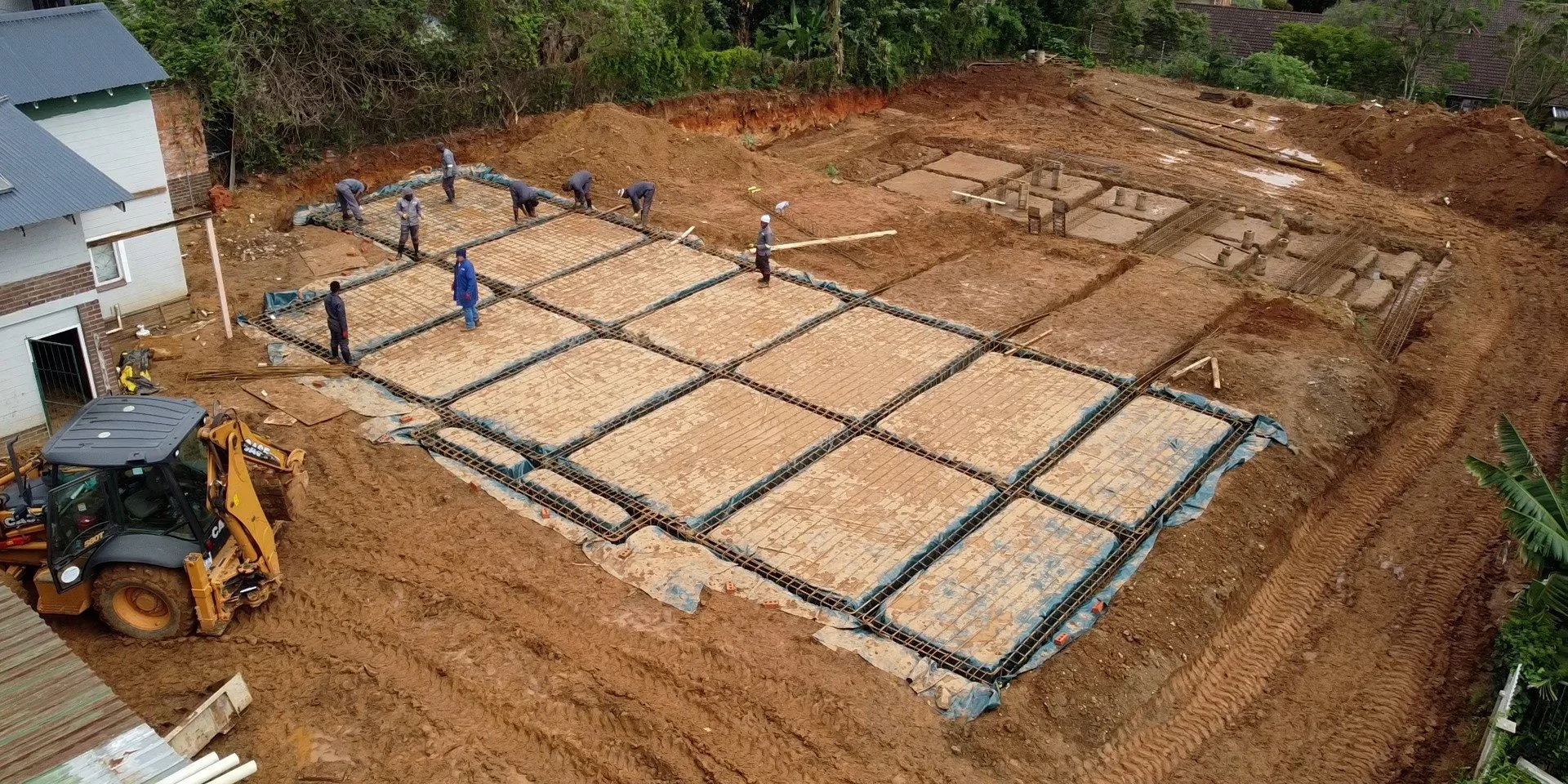

Reinforced concrete slabs were cast, providing the solid foundation needed to support our new office facility.

Graphic
04

12 January 2024Back Wall Construction

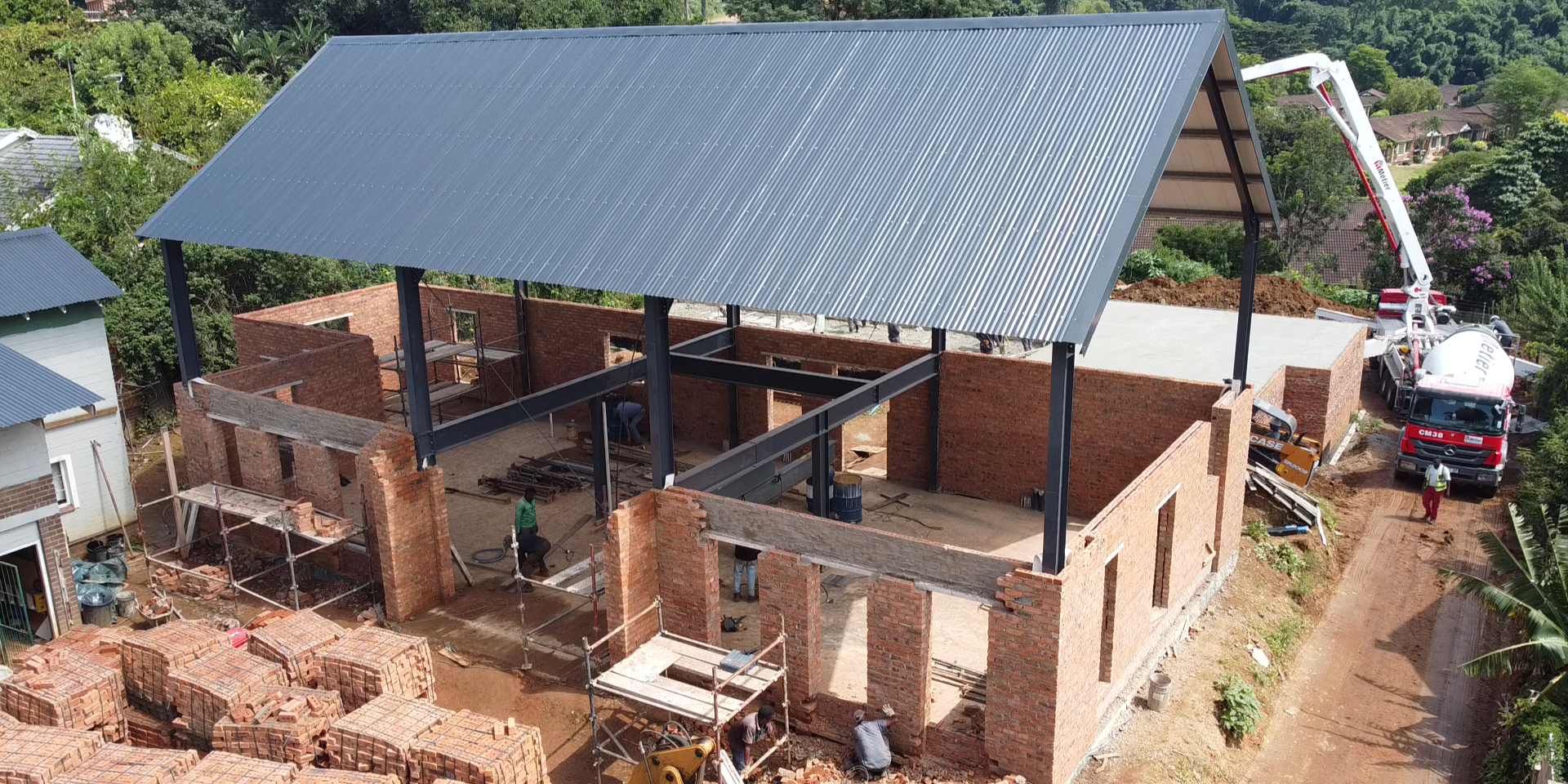

The reinforced concrete slabs for both the front and rear sections of the building have been poured, and construction of the rear walls is now underway, forming the structure’s initial vertical elements.

Graphic
05

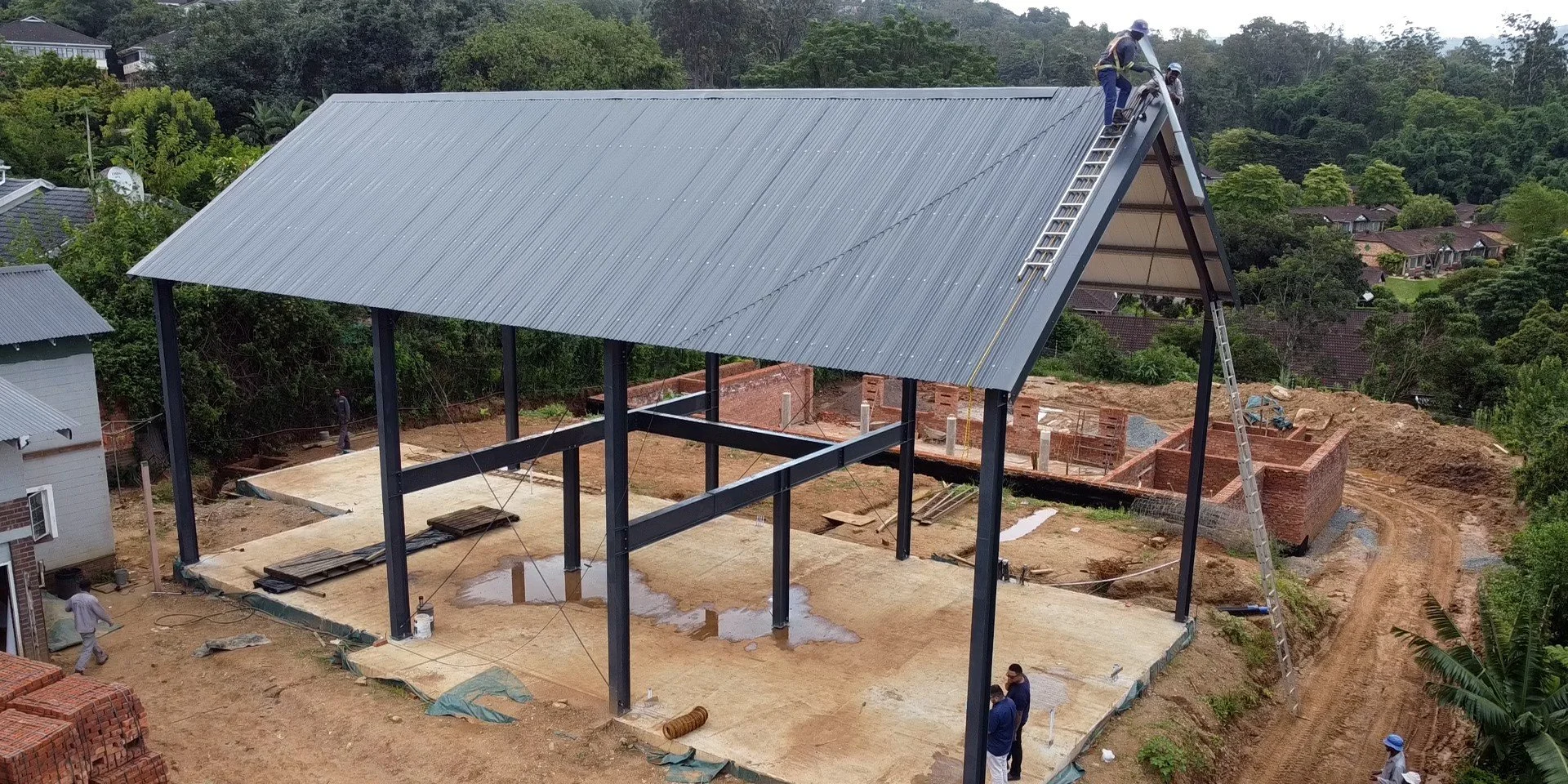

19 January 2024Front Section Steel Frame

The steel framework and roof for the front section of the building have been completed, establishing the primary structural support and weatherproofing for this area.

Graphic
06

29 January 2024First Floor Walls

Construction of the first-floor walls has begun, marking the start of the vertical expansion above the ground floor and defining the building’s upper-level layout.

Graphic
07

12 February 2024Second Floor Preparation

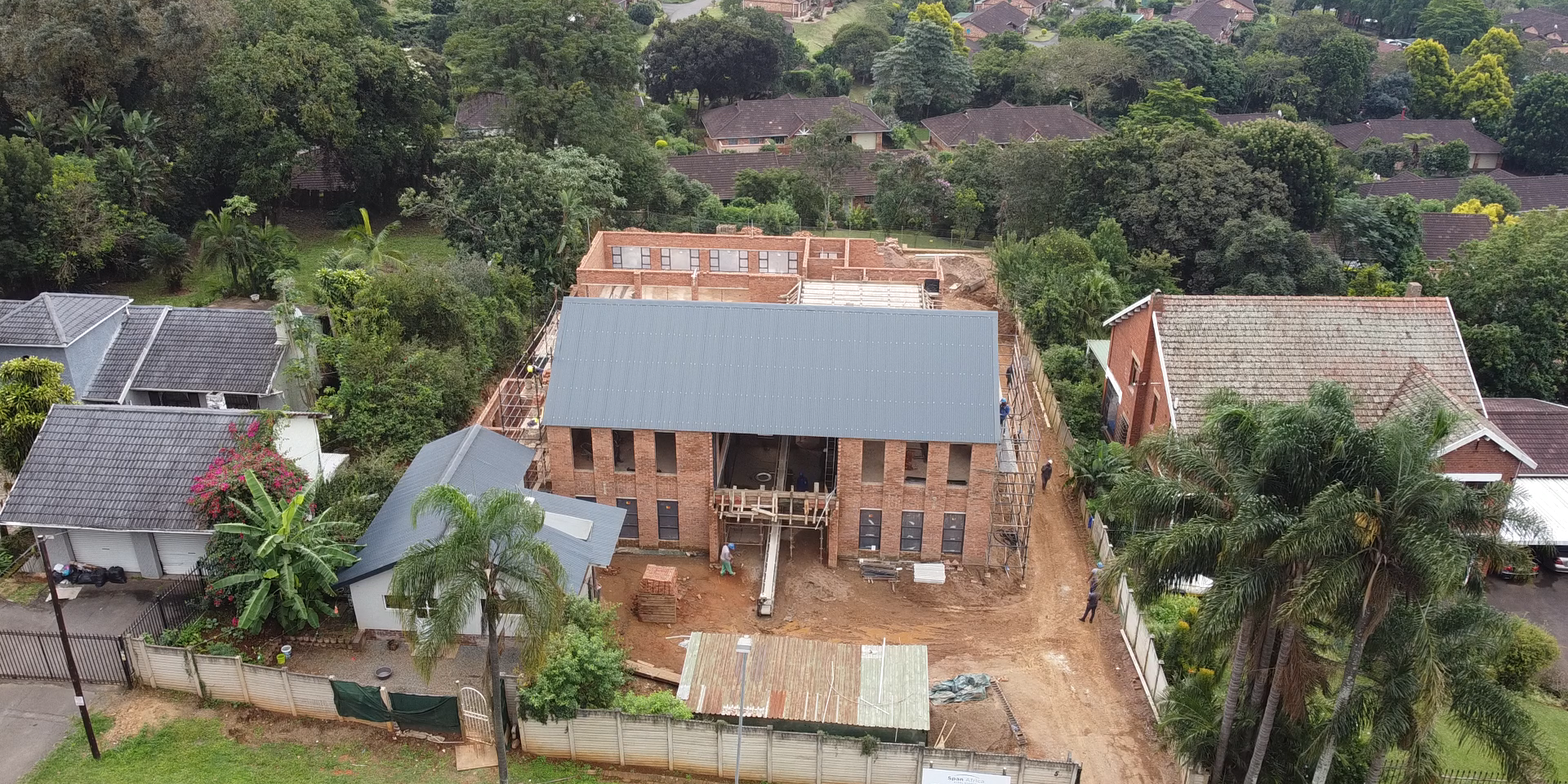

Preparatory work is underway for the construction of the second-floor walls on the rear section of the building, setting out the structure for the upper level.

Graphic
08

20 February 2024Building Connection

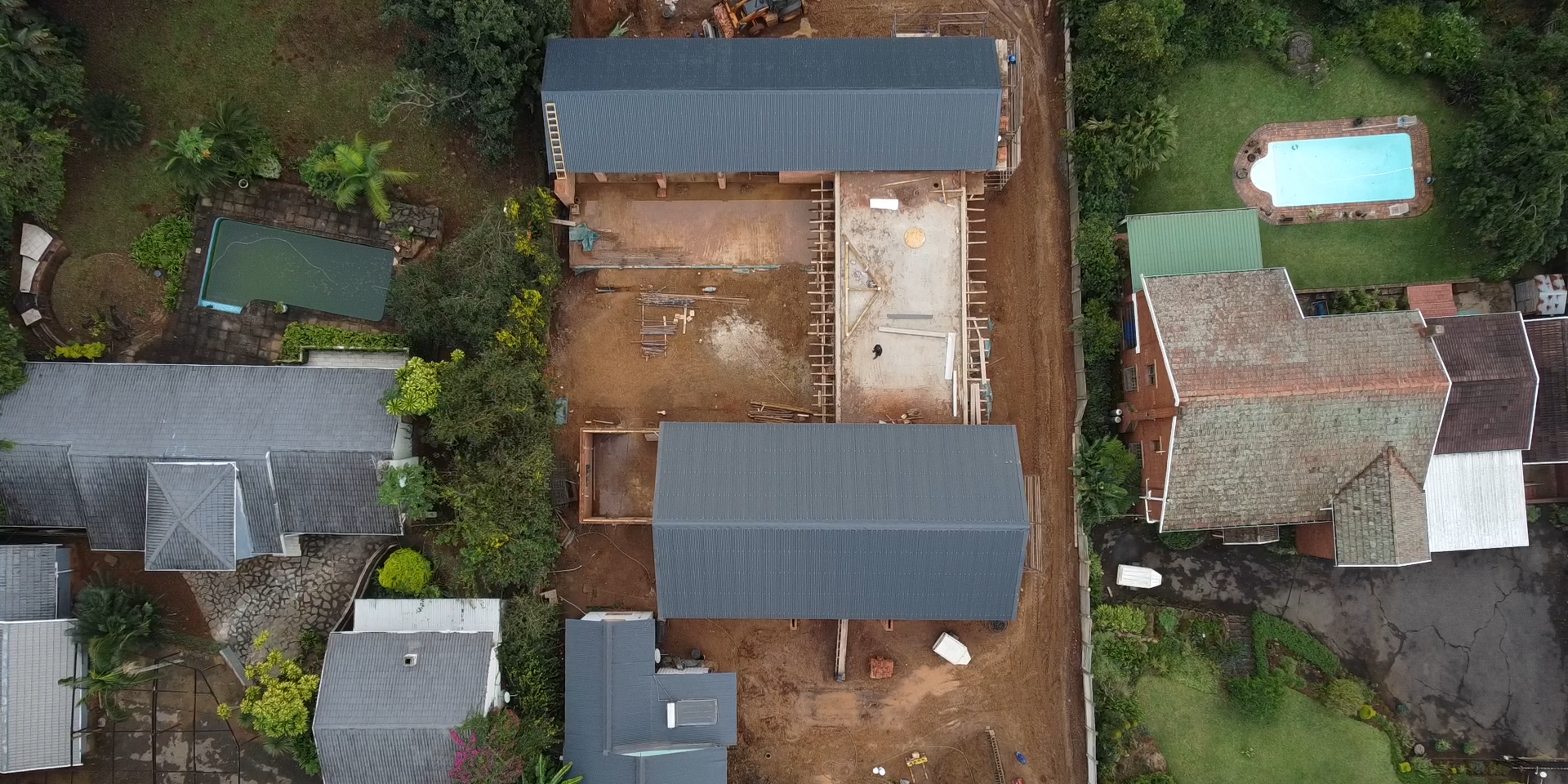

Preparations for the top-floor walls on the front building are underway, alongside the construction of the structural connection between the front and rear sections, integrating both parts of the facility.

Graphic
09

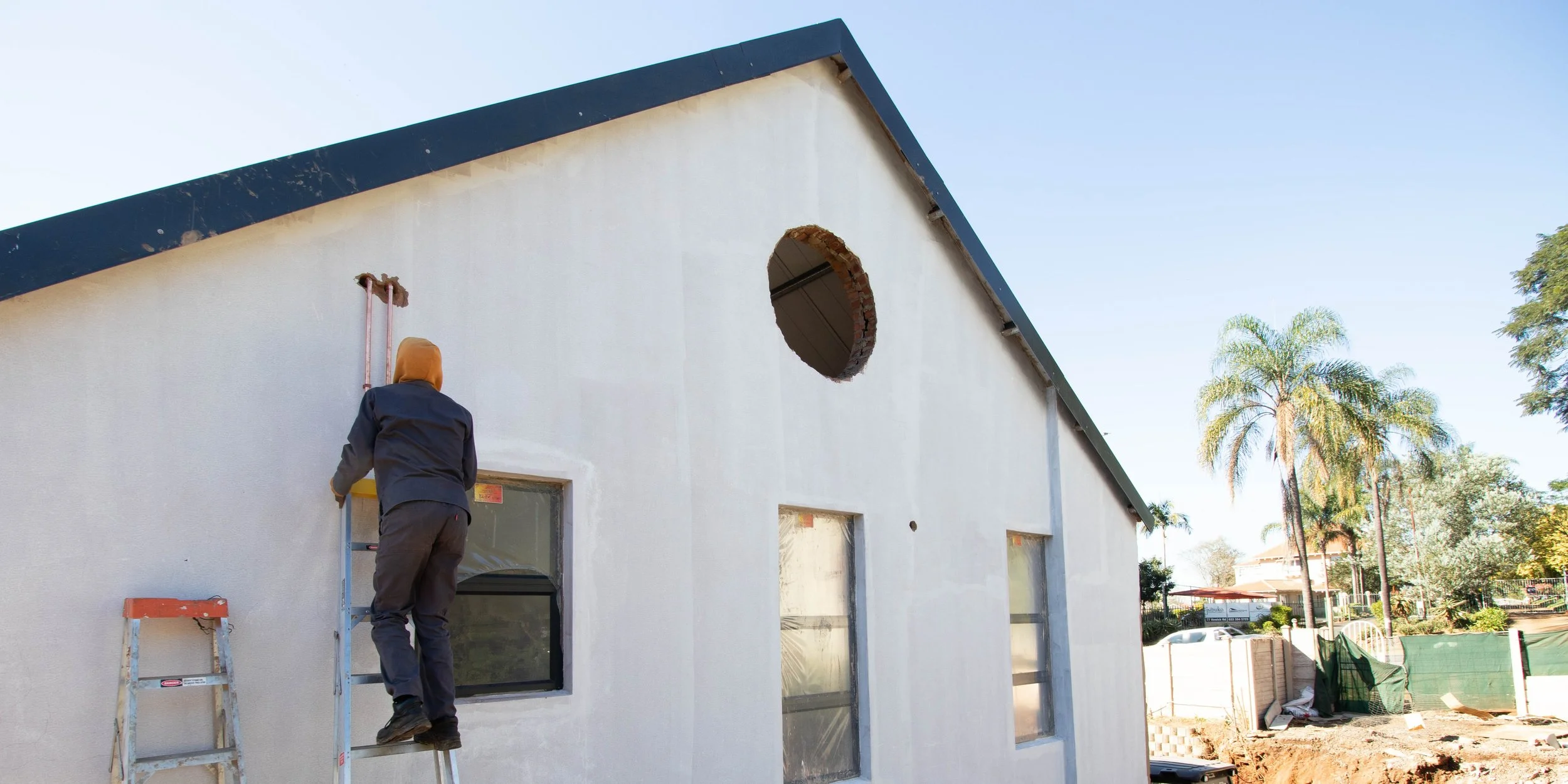

15 April 2024Top Floor External Walls

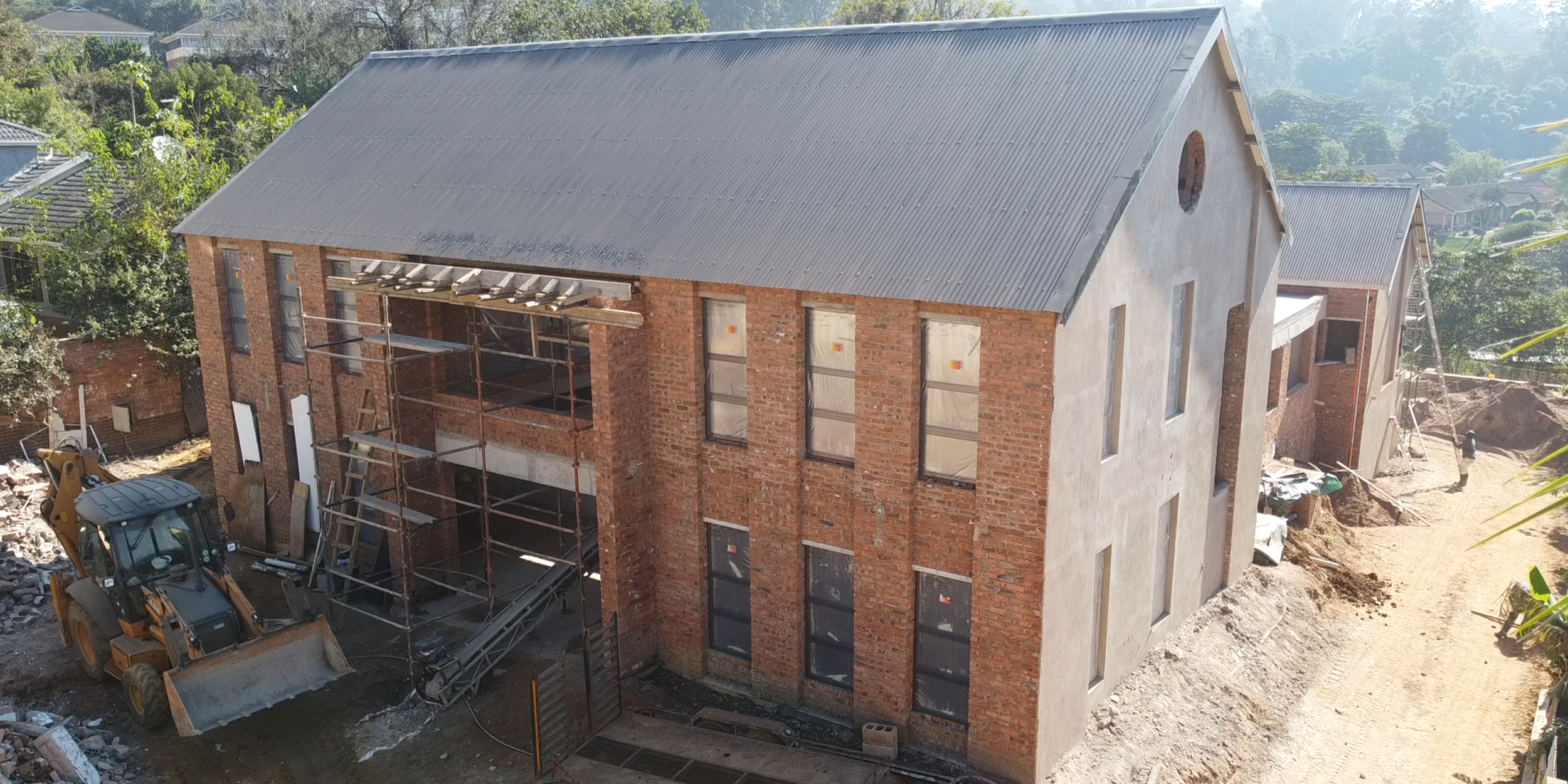

Construction of the top-floor external walls for the front building is now complete, defining the full vertical envelope of this section.

Graphic
10

29 April 2024Internal Walls & Fixtures

Work has commenced on internal walls and fixtures within the front building, shaping the interior spaces and beginning the fit-out process.

Graphic
11

17 May 2024Rear Building Completion

Construction of the rear building’s walls is complete, and the roof has been installed, finalizing the main structural envelope of this section.

Graphic
12

28 May 2024Window Installation

Windows are being installed throughout the building as internal construction and fit-out work continue, bringing natural light into the spaces and progressing towards a functional interior.

Graphic
13

12 June 2024Exterior Painting

Exterior painting has commenced, while finishing touches and final construction works are being completed, preparing the building for practical completion.

Graphic
14

30 June 2024Final Construction

The last construction elements and finishing details are being completed, bringing the building closer to full readiness for occupation.

Graphic
15

August 2024Completed Office Building

After a period of final inspections and preparation, the building is now fully complete, showcasing the finished design and construction quality of our new offices.

Graphic
16

October 2024Move-In

Our team has moved into the new office, setting up operations and bringing the facility to life as our fully functional headquarters.

Graphic
